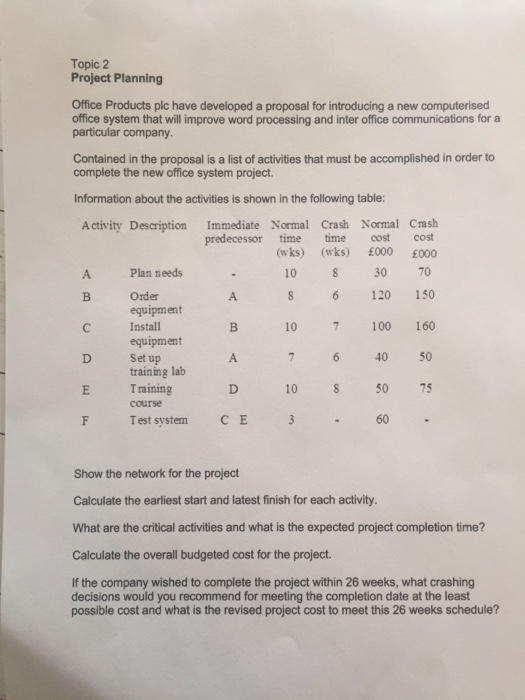

Expert Answer
Network of the project along with their normal time mentioned within “()” as follows:
A (10) | |
B (8) | D (7) |
C (10) | E (10) |
F (3) |
Early start / Late start/ Early finish / Late Finish for each activity as follows:
Activity | Early Start | Early Finish | Late Start | Late finish |
A | 0 | 10 | 0 | 10 |
B | 10 | 18 | 10 | 18 |
C | 18 | 28 | 18 | 28 |
D | 10 | 17 | 10 | 17 |
E | 17 | 27 | 17 | 27 |
F | 27 | 30 | 28 | 31 |
Determination of critical activity:
Duration of activity A – D – E: 27 weeks
Duration of activity A – B – C: 28 weeks
Since F can start after completion of activity C as well as activity E and since C completes later than E,
The Critical path will be: A – B – C – F with duration of critical path = 28 + 3 = 31 weeks
Therefore, expected project completion time = 31 weeks
Overall budgeted cost for the project:
Activity | Normal Cost (GBP ‘000) |
A | 30 |
B | 120 |
C | 100 |
D | 40 |
E | 50 |
F | 60 |
Total Cost (i.e. sum of Normal costs of all activities): | 400 |
Therefore, total budgeted cost for the project = GBP 400,000
Crashing decision to complete the project within 26 weeks at least cost :
Completion of project within 26 weeks means reducing project duration by 31 – 26 = 5 weeks which will be done in following manner:
Activity | Reduction of duration by | Crashing cost ( GBP ‘000) |
F | 3 | 0 |
A | 2 | 70 |
Total Crashing Cost ( Sum of all Crashing costs ) | 70 |
Revised Project cost
= Total budgeted cost of the project + Total crashing cost
= GBP 400,000 + GBP 70,000
= GBP 470,000
